EXECUTIVE SUMMARY

Central Kowloon Route – Kai Tak West (CKR-KTW; Contract No. HY/2014/07) (hereafter called “the Project”) covers part of the construction of the Central Kowloon Route (CKR).

The Project comprises the follow works:

·     50x30m access shaft with noise enclosure at Ma Tau Kok (MTK);

·     100m long cut-and-cover (C&C) tunnel at MTK;

·     Demolition and re-provisioning of MTK Public Pier;

·     160m long underwater tunnel (UWT) (Stage 1);

·     210m long UWT (Stage 2);

·     60m long C&C tunnel at Kai Tak;

·     130m long depressed road and 200m long underpass at Kai Tak;

·     390m long underground tunnel ventilation audit at Kai Tak;

·     Seawall demolition and construction of new landing steps; and

·     Barging Point enclosure and conveyor system.

The EM&A programme commenced on 4 April 2018.The impact EM&A for the Project includes air quality and noise monitoring.

This is the 80th monthly EM&A Report presenting the EM&A works carried out during the period between 1 and 30 November 2024. As informed by the Contractor, major activities in the reporting period were:

Locations

Site Activities

Kai Tak

- Defect rectification works at underpass, depressed road and C&C
- Channel construction at the roof of ventilation adit

Ma Tau Kok

- Temporary traffic management (TTM) implementation;
- Removal of Excavation and Lateral Support (ELS) at MTK C&C Tunnel;
- Backfilling at MTK C&C Tunnel;
- Road paving at MTK C&C Tunnel;
- Drainage Construction in MTK

Kowloon Bay

- Removal of Excavation and Lateral Support (ELS) at Stage 2 UWT;
- Backfilling at Stage 2 UWT;
- Road paving at Stage 2 UWT;
- Removal of temporary reclamation at Stage 2 Marine Platform;
- Re-construction of Ma Tau Kok Public Pier

Breaches of Action and Limit Levels for Air Quality

All 24-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.

All 1-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.

Breaches of Action and Limit Levels for Noise

Regular Noise Monitoring

No exceedance of Action and Limit level of noise was recorded in the reporting month.

Complaint, Notification of Summons and Successful Prosecution

One (1) complaint was received in the reporting month (November 2024). The complaint was investigated and have been provided in this reporting month (November 2024).

Reporting Changes

No report changes in the reporting period.

Future Key Issues

Key issues to be considered in the next three months included:

Locations

Site Activities

Kai Tak

- Defect rectification works at underpass, depressed road and C&C
- Channel construction at the roof of ventilation adit

Ma Tau Kok

- TTM implementation;
- Asphalt paving at MTK C&C Tunnel;
- Dismantel of MTK Traffic Deck;
- Drainage Construction in MTK.

Kowloon Bay

- Removal of Excavation and Lateral Support (ELS) at Stage 2 UWT;
- Backfilling at Stage 2 UWT;
- Asphalt paving at Stage 2 UWT;
- Dismantle of Temporary Stage 2 Marine Platform;
- MTK seawall reinstatement;
- Re-construction of Ma Tau Kok Public Pier

Potential environmental impacts arising from the above construction activities are mainly associated with construction dust, construction noise, water pollution control, and waste management.

1              INTRODUCTION

Gammon Construction Limited was commissioned by the Highways Department as the Civil Contractor for Works Contract HY/2014/07. AECOM Asia Company Limited (AECOM) was appointed by Gammon Construction Limited as the Environmental Team (ET) to undertake the Environmental Monitoring and Audit (EM&A) programme during construction phase of the Project.

1.1          Purpose of the Report

1.1.1          This is the 80th monthly EM&A Report which summaries the impact monitoring results and audit findings for the Project during the reporting period between 1 and 30 November 2024.

1.2          Report Structure

1.2.1          This monthly EM&A Report is organized as follows:

·     Section 1: Introduction

·     Section 2: Project Information

·     Section 3: Environmental Monitoring Requirement

·     Section 4: Implementation Status of Environmental Mitigation Measures

·     Section 5: Monitoring Results

·     Section 6: Environmental Site Inspection and Audit

·     Section 7: Environmental Non-conformance

·     Section 8: Future Key Issues

·     Section 9: Conclusions and Recommendations

2              Project Information

2.1          Background

2.1.1          CKR is a dual 3-lane trunk road across central Kowloon linking the West Kowloon in the west and the Kai Tak Development (KTD) in the east. The CKR will be about 4.7 km long with an underground tunnel section of about 3.9 km long, in particular, there will be an underwater tunnel of about 370 m long in Kowloon Bay to the north of the To Kwa Wan Typhoon Shelter. It will connect the West Kowloon Highway at Yau Ma Tei Interchange with the road network at Kowloon Bay and the future Trunk Road T2 at KTD which will connect to the future Tseung Kwan O – Lam Tin Tunnel (TKO-LTT) and Cross Bay Link (CBL). CKR, Trunk Road T2 and TKO-LTT will form a strategic highway link, namely Route 6, connecting West Kowloon and Tseung Kwan O. In addition, 3 ventilation buildings, which will be located in Ya Ma Tei, Ho Man Tin and ex-Kai Tak airport area, are proposed to ensure acceptable air quality within the tunnel.

2.1.2          The Environmental Impact Assessment (EIA) Report for Central Kowloon Route (Register No.: AEIAR-171/2013) was approved on 11 July 2013 under the Environmental Impact Assessment Ordinance (EIAO). Following the approval of the EIA Report, an Environmental Permit (EP) for CKR was granted on 9 August 2013 (EP No.: EP- 457/2013) for the construction and operation. Variation of EP (VEP) was subsequently applied and the latest EP (EP No. EP-457/2013/D) was issued by the Director of Environmental Protection (DEP) on 15 June 2021. Further Environmental Permit (EP No. FEP-01/457/2013/C) for CKR – Kai Tak West was issued on 28 February 2018.

2.1.3          The construction of the CKR had been divided into different sections. This Work Contract HY/2014/07 – Kai Tak West (KTW) (“The Project”) will include a road which is a trunk road, including new roads, and major extensions or improvements to existing roads; a road fully enclosed by decking above and by structure on the sides for more than 100 m; and reclamation works (including associated dredging works) more than 1 ha in size and a boundary of which is less than 100 m from an existing residential area.

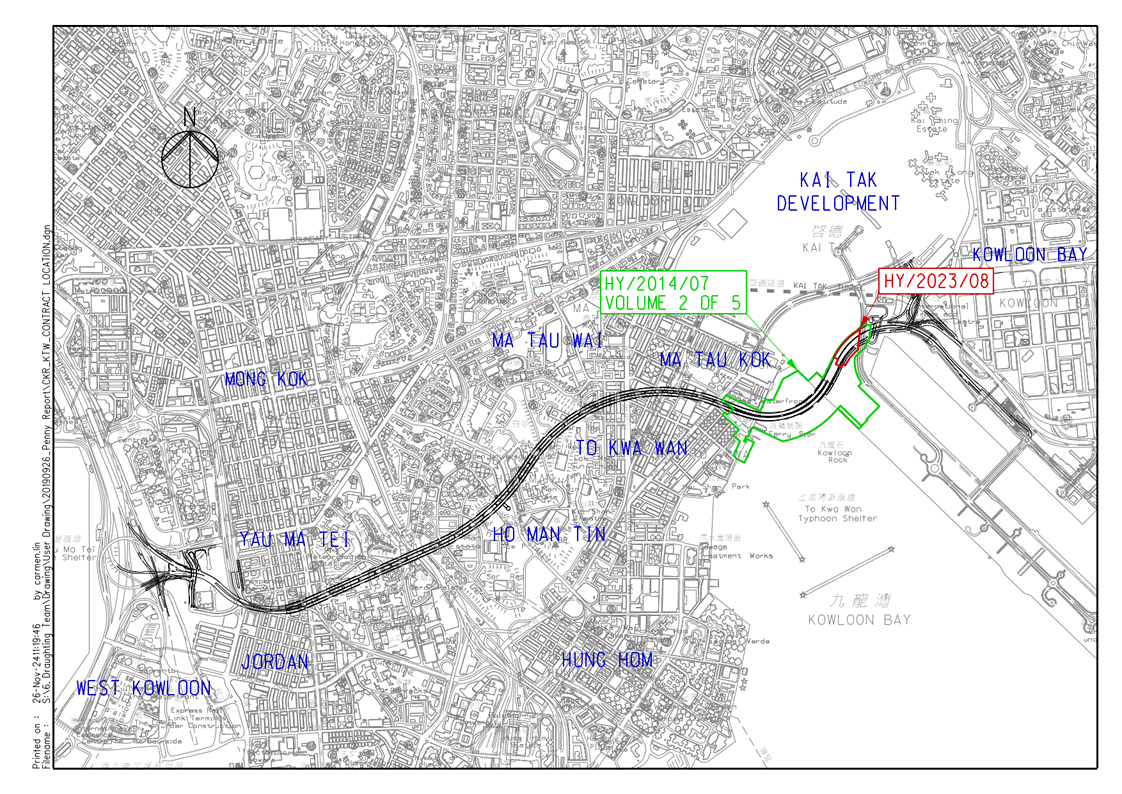

2.1.4          The site layout plan of the Project is shown in Figure 1.1.

2.2          Site Description

2.2.1          The major construction activities under this Project include:

(a)   construction of approximately 160m long cut-and-cover tunnel and 370m long underwater tunnel between the tunnel section at Ma Tau Kok and the depressed road of the CKR within Kai Tak Development;

(b)   reconstruction of the seawall at Ma Tau Kok public pier, and the sloping seawall at the Former Kai Tak Airport Runway;

(c)   construction of approximately 125m long depressed road and 200m long underpass of the CKR within Kai Tak Development;

(d)   construction of approximately 360m long underground tunnel ventilation adit of the CKR;

(e)   reconstruction of Kowloon City Ferry Pier Public Transport Interchange; and

(f)    other associated works.

2.3          Construction Programme and Activities

2.3.1          The major construction activities undertaken in the reporting month are summarized in Table 2.1.

Table 2.1          Construction Activities in the reporting month

Locations

Site Activities

Kai Tak

- Defect rectification works at underpass, depressed road and C&C
- Channel construction at the roof of ventilation adit

Ma Tau Kok

- Temporary traffic management (TTM) implementation;
- Removal of Excavation and Lateral Support (ELS) at MTK C&C Tunnel;
- Backfilling at MTK C&C Tunnel;
- Road paving at MTK C&C Tunnel;
- Drainage Construction in MTK

Kowloon Bay

- Removal of Excavation and Lateral Support (ELS) at Stage 2 UWT;
- Backfilling at Stage 2 UWT;
- Road paving at Stage 2 UWT;
- Removal of temporary reclamation at Stage 2 Marine Platform;
- Re-construction of Ma Tau Kok Public Pier

2.3.2          The construction programme is presented in Appendix A.

2.4          Project Organization

2.4.1          The project organization structure is shown in Appendix B. The key personnel contact names and numbers for the Project are summarized in Table 2.2.

Table 2.2          Contact Information of Key Personnel

Party

Role

Position

Name

Telephone

Fax

Arup-Mott MacDonald Joint Venture

Residential Engineer (ER)

Engineer’s Representative

Mr. Patrick Lo

36195901

2268 3954

ERM

Independent Environmental Checker (IEC)

Independent Environmental Checker

Ms. Mandy To

2271 3113

3015 8052

Gammon

Contractor

Contracts Manager

Mr. Kin Fai Tam

2516 8823

2516 6260

Environmental Manager

Ms. Michelle Tang

9267 8866

2516 6260

AECOM

Contractor’s Environmental Team (ET)

ET Leader

Mr. Y. W. Fung

3856 5681

2317 7609

2.5          Status of Environmental Licences, Notification and Permits

2.5.1          Relevant environmental licenses, permits and/or notifications on environmental protection for this Project and valid in the reporting month are summarized in Table 2.3.

Table 2.3          Status of Environmental Licenses, Notifications and Permits

Permit / License No. / Notification/ Reference No.

Valid Period

Status

Remarks

From

To

Further Environmental Permit

FEP-01/457/2013/C

28 Feb 2018

End of Project

Valid

--

Wastewater Discharge License

WT00043692-2023

1 Apr 2023

31 Mar 2028

Valid

Ma Tau Kok

WT00043881-2023

30 Jun 2023

30 Jun 2028

Valid

Underwater Tunnel

Stage 2

WT00044013-2023

1 May 2023

30 Apr 2028

Valid

Kai Tak and Underwater Tunnel Stage 1

Construction Noise Permit

GW-RE0618-24

1 Jun 2024

30 Nov 2024

Valid

General Works at Ma Tau Kok

GW-RE1173-24

1 Oct 2024

31 Mar 2025

Valid

General Works at Kai Tak

GW-RE1300-24

21 Oct 2024

20 Apr 2025

Valid

General Works at Promenade

GW-RE0585-24

GW-RE1423-24

19 May 2024

19 Nov 2024

18 Nov 2024

18 May 2025

Expired

Valid

General Works at Stage 1 Underwater Tunnel

GW-RE0627-24

7 Jun 2024

6 Dec 2024

Valid

General Works at Stage 2 Underwater Tunnel

GW-RE1149-24

19 Sep 2024

18 Mar 2025

Valid

Kai Tak Access Road

Chemical Waste Producer Registration

5118-247-G2347-47

30 Jan 2018

End of Project

Valid

--

5118-247-G2347-48

30 Jan 2018

End of Project

Valid

--

Marine Dumping Permit

--

--

--

--

--

Billing Account for Construction Waste Disposal

7029909

22 Jan 2018

End of Project

Account Active

--

Notification Under Air Pollution Control (Construction Dust) Regulation

429442

5 Jan 2018

5 Jul 2025

Notified

--

3              Environmental Monitoring Requirements

3.1          Construction Dust Monitoring

Monitoring Requirements

3.1.1          In accordance with the approved EM&A Manual, measurement of 24-hour and 1-hour Total Suspended Particulates (TSP) level at the designated air quality monitoring station is required. Impact 24-hour TSP monitoring should be carried out for at least once every 6 days, and 1-hour TSP monitoring should be done at least 3 times every 6 days while the highest dust impact is expected. The Action and Limit Levels of the air quality monitoring is provided in Appendix D.

Monitoring Equipment

3.1.2          24-hour TSP air quality monitoring was performed using High Volume Sampler (HVS) located at the designated monitoring station. The HVS meets all the requirements of the EM&A Manual.

3.1.3          A portable direct reading dust meter was used to carry out the 1-hour TSP monitoring.

3.1.4          Brand and model of the equipment is given in Table 3.1.

Table 3.1         Air Quality Monitoring Equipment

Equipment

Brand and Model

High Volume Sampler
(24-hour TSP)

Tisch Total Suspended Particulate Mass Flow Controlled High Volume Air Sampler
(Model No. TE-5170)

Calibration Kit

(24-hour TSP)

TISCH Environmental Orifice
(Model TE-5025A)

Portable direct reading dust meter
(1-hour TSP)

Sibata Digital Dust Monitor
(Model No. LD-3 & LD-3B)

Monitoring Locations

3.1.5          The monitoring station for construction dust monitoring pertinent to the Project has been identified based on the approved EM&A Manual for the Project.  The location of the construction dust monitoring station is summarized in Table 3.2 and shown in Figure 3.1.

Table 3.2         Location of Construction Dust Monitoring Station

Location

Monitoring Station

Description

E-A14a [1]

Block B of Merit Industrial Centre

Rooftop (13/F)

Note:

[1] The air monitoring station proposed in the EM&A Manual (i.e. Wyler Gardens with ID: E-A14) was not available for impact dust monitoring, therefore impact monitoring was conducted at E-A14a as an alternative which was agreed by the ER, IEC and EPD.

Monitoring Methodology

3.1.6          24-hour TSP Monitoring

(a)           The HVS was installed in the vicinity of the air sensitive receivers.  The following criteria were considered in the installation of the HVS as far as practicable: -

(i)            A horizontal platform with appropriate support to secure the sampler against gusty wind was provided.

(ii)           Two samplers should not be placed less than 2m apart from each other;

(iii)          The distance between the HVS and any obstacles, such as buildings, was at least twice the height that the obstacle protrudes above the HVS.

(iv)          A minimum of 2 meters separation from walls, parapets and penthouse for rooftop sampler.

(v)           A minimum of 2 meters separation from any supporting structure, measured horizontally is required.

(vi)          No furnace or incinerator flues nearby.

(vii)         Airflow around the sampler was unrestricted.

(viii)        The sampler was located more than 20 meters from any dripline.

(ix)          Any wire fence and gate, required to protect the sampler, did not obstruct the monitoring process.

(x)           Permission was obtained to set up the samplers and access to the monitoring station.

(xi)          A secured supply of electricity was obtained to operate the sampler.

(b)           Preparation of Filter Papers

(i)            Glass fibre filters, G810 were labelled and sufficient filters that were clean and without pinholes were selected.

(ii)           All filters were equilibrated in the conditioning environment for 24 hours before weighing. The conditioning environment temperature was around 25 °C and not variable by more than ±3 °C; the relative humidity (RH) was < 50% and not variable by more than ±5%. A convenient working RH was 40%.

(iii)          All filter papers were prepared and analysed by ALS Technichem (HK) Pty Ltd., which is a HOKLAS accredited laboratory and has comprehensive quality assurance and quality control programmes.

(c)           Field Monitoring

(i)            The power supply was checked to ensure the HVS works properly.

(ii)           The filter holder and the area surrounding the filter were cleaned.

(iii)          The filter holder was removed by loosening the four bolts and a new filter, with stamped number upward, on a supporting screen was aligned carefully.

(iv)          The filter was properly aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter.

(v)           The swing bolts were fastened to hold the filter holder down to the frame. The pressure applied was sufficient to avoid air leakage at the edges.

(vi)          Then the shelter lid was closed and was secured with the aluminium strip.

(vii)         The HVS was warmed-up for about 5 minutes to establish run-temperature conditions.

(viii)        A new flow rate record sheet was set into the flow recorder.

(ix)          On site temperature and atmospheric pressure readings were taken and the flow rate of the HVS was checked and adjusted at around 1.3 m3/min, and complied with the range specified in the EM&A Manual (i.e. 0.6-1.7 m3/min).

(x)           The programmable digital timer was set for a sampling period of 24 hrs, and the starting time, weather condition and the filter number were recorded.

(xi)          The initial elapsed time was recorded.

(xii)         At the end of sampling, on site temperature and atmospheric pressure readings were taken and the final flow rate of the HVS was checked and recorded.

(xiii)        The final elapsed time was recorded.

(xiv)        The sampled filter was removed carefully and folded in half length so that only surfaces with collected particulate matter were in contact.

(xv)         It was then placed in a clean envelope and sealed.

(xvi)        All monitoring information was recorded on a standard data sheet.

(xvii)       Filters were then sent to ALS Technichem (HK) Pty Ltd. for analysis.

(d)           Maintenance and Calibration

(i)            The HVS and its accessories were maintained in good working condition, such as replacing motor brushes routinely and checking electrical wiring to ensure a continuous power supply.

(ii)           HVSs were calibrated using TE-5025A Calibration Kit upon installation and thereafter at bi-monthly intervals.

(iii)          Calibration certificate of the TE-5025A Calibration Kit and the HVSs are provided in Appendix E.

3.1.7          1-hour TSP Monitoring

(a)           Measuring Procedures

The measuring procedures of the 1-hour dust meter are in accordance with the Manufacturer’s Instruction Manual as follows:

(i)            Turn the power on.

(ii)           Close the air collecting opening cover.

(iii)          Push the “TIME SETTING” switch to [BG]

(iv)          Push “START/STOP” switch to perform background measurement for 6 seconds.

(v)           Turn the knob at SENSI ADJ position to insert the light scattering plate.

(vi)          Leave the equipment for 1 minute upon “SPAN CHECK” is indicated in the display.

(vii)         Push “START/STOP” switch to perform automatic sensitivity adjustment. This measurement takes 1 minute.

(viii)        Pull out the knob and return it to MEASURE position.

(ix)          Push the “TIME SETTING” switch the time set in the display to 3 hours.

(x)           Lower down the air collection opening cover.

(xi)          Push “START/STOP” switch to start measurement.

(b)           Maintenance and Calibration

(i)            The 1-hour TSP meter was calibrated at 1-year intervals against a High Volume Samplers.  Calibration certificates of the Laser Dust Monitors are provided in Appendix E.

Monitoring Schedule for the Reporting Month

3.1.8          The schedule for environmental monitoring in November 2024 is provided in Appendix F.

3.2        Construction Noise Monitoring

Monitoring Requirements

3.2.1          In accordance with the EM&A Manual, impact noise monitoring should be conducted for at least once a week during the construction phase of the Project. Table 3.3 summarizes the monitoring parameters, frequency and duration of impact noise monitoring. The Action and Limit Levels of the noise monitoring is provided in Appendix D.

Table 3.3         Noise Monitoring Parameters, Frequency and Duration

Parameter and Duration

Frequency

30-mins measurement at each monitoring station between 0700 and 1900 on normal weekdays. Leq, L10 and L90 would be recorded.

At least once per week

Monitoring Equipment

3.2.2          Noise monitoring was performed using sound level meter at each designated monitoring station.  The sound level meters deployed comply with the International Electrotechnical Commission Publications (IEC) 651:1979 (Type 1) and 804:1985 (Type 1) specifications.  Acoustic calibrator was deployed to check the sound level meters at a known sound pressure level.  Brand and model of the equipment is given in Table 3.4.

Table 3.4         Noise Monitoring Equipment for Regular Noise Monitoring

Equipment

Brand and Model

Integrated Sound Level Meter

B&K (Model No. 2250 & 2250L)

Acoustic Calibrator

B&K (Model No. 4231)

Rion(Model No. NC-74)

MVI(Model No. CAL21)

Monitoring Locations

3.2.3          The monitoring stations for construction noise monitoring pertinent to the Project have been identified based on the approved EM&A Manual for the Project.  Locations of the noise monitoring stations are summarized in Table 3.5 and shown in Figure 3.2.

Table 3.5         Noise Monitoring Stations during Construction Phase

Location

Monitoring Station

Description

Measurement

E-N12a [1]

19 Hing Yan Street

Rooftop (9/F)

Façade

E-N21a [1]

Block B of Merit Industrial Centre

Rooftop (13/F)

Free field[2]

Notes:

[1] The noise monitoring stations proposed in the EM&A Manual (i.e. Grand Waterfront Tower 3 with ID: E-N12 and Hang Chien Court Block J with ID: E-N21) were not available for impact noise monitoring, therefore impact monitoring was conducted at E-N12a and E-N21a as an alternative which was agreed by the ER, IEC and EPD.

[2]  A correction of +3 dB(A) was made to the free field measurements.

Monitoring Parameters, Frequency and Duration

3.2.4          Table 3.6 summarizes the monitoring parameters, frequency and duration of impact noise monitoring.

Table 3.6         Noise Monitoring Parameters, Frequency and Duration

Location

Parameter and Duration

Frequency

E-N12a and E-N21a

30-mins measurement at each monitoring station between 0700 and 1900 on normal weekdays. Leq, L10 and L90 would be recorded.

At least once per week

Monitoring Methodology

3.2.5          Monitoring Procedure

(a)           The sound level meter was set on a tripod at a height of 1.2 m above the ground.

(b)           Façade measurement was made at E-N12a.

(c)           Free field measurements was made at monitoring location E-N21a. A correction of +3 dB(A) shall be made to the free field measurements.

(d)           The battery condition was checked to ensure the correct functioning of the meter.

(e)           Parameters such as frequency weighting, the time weighting and the measurement time were set as follows:

(i)            frequency weighting

(ii)           time weighting: Fast

(iii)          time measurement: Leq(30-minutes) during non-restricted hours i.e. 0700 – 1900 on normal weekdays.

(f)            Prior to and after each noise measurement, the meter was calibrated using the acoustic calibrator for 94 dB(A) at 1000 Hz.  If the difference in the calibration level before and after measurement was more than 1 dB(A), the measurement would be considered invalid and repeat of noise measurement would be required after re-calibration or repair of the equipment.

(g)           During the monitoring period, the Leq, L10 and L90 were recorded.  In addition, site conditions and noise sources were recorded on a standard record sheet.

(h)           Noise measurement was paused during periods of high intrusive noise (e.g. dog barking, helicopter noise) if possible. Observations were recorded when intrusive noise was unavoidable.

(i)            Noise monitoring was cancelled in the presence of fog, rain, wind with a steady speed exceeding 5m/s, or wind with gusts exceeding 10m/s.

3.2.6          Maintenance and Calibration

(a)           The microphone head of the sound level meter was cleaned with soft cloth at regular intervals.

(b)           The meter and calibrator were sent to the supplier or HOKLAS laboratory to check and calibrate at yearly intervals.

(c)           Calibration certificates of the sound level meters and acoustic calibrators are provided in Appendix E.

Monitoring Schedule for the Reporting Month

3.2.7          The schedule for environmental monitoring in November 2024 is provided in Appendix F.

3.3          Landscape and Visual

3.3.1          As per the EM&A Manuals, the landscape and visual mitigation measures shall be implemented and site inspections should be undertaken once every two weeks during the construction period. A summary of the implementation status is presented in Section 6.

4              Implementation Status of Environmental Mitigation Measures

4.1.1          The Contractor has implemented environmental mitigation measures and requirements as stated in the EIA Reports, the EP and EM&A Manuals. The implementation status of the environmental mitigation measures during the reporting period is summarized in Appendix C. Status of required submissions under the EP during the reporting period is summarised in Table 4.1.

Table 4.1          Status of Required Submission under Environmental Permit

EP Condition

Submission

Submission Date

Condition 3.4 of
EP-457/2013/D
and
Condition 3.4 of
FEP-01/457/2013/C

Monthly EM&A Report for

 October 2024

14 November 2024

5              Monitoring Results

5.1          Construction Dust Monitoring

5.1.1          The monitoring results for 24-hour TSP and 1-hour TSP are summarized in Table 5.1 and Table 5.2 respectively.  Detailed air quality monitoring results and daily extract of meteorological observations are presented in Appendix G.

Table 5.1         Summary of 24-hour TSP Monitoring Result in the Reporting Period

ID

Average (mg/m3)

Range (mg/m3)

Action Level (mg/m3)

Limit Level (mg/m3)

E-A14a

42.2

26.0 - 60.8

197.3

260

Table 5.2         Summary of 1-hour TSP Monitoring Result in the Reporting Period

ID

Average (mg/m3)

Range (mg/m3)

Action Level (mg/m3)

Limit Level (mg/m3)

E-A14a

61.1

57.7 – 63.5

302.4

500

5.1.2          No Action and Limit Level exceedance was recorded for 24-hour TSP monitoring at the monitoring location in the reporting month.

5.1.3          No Action and Limit Level exceedance was recorded for 1-hour TSP monitoring at the monitoring location in the reporting month.

5.1.4          The event and action plan are annexed in Appendix I.

5.1.5          Major dust sources during the monitoring included construction dust and nearby traffic emission.

5.2          Regular Construction Noise Monitoring

5.2.1          The monitoring results for noise are summarized in Table 5.3 and the monitoring data is provided in Appendix H.

Table 5.3         Summary of Construction Noise Monitoring Results in the Reporting Period

ID

Range, dB(A), Leq (30 mins)

Limit Level, dB(A), Leq (30 mins)

E-N12a

62.9 – 64.2

75

E-N21a

58.0 – 58.6

75

5.2.2          No exceedance of Action and Limit level of noise was recorded in the reporting month.

5.2.3          The event and action plan are annexed in Appendix I.

5.2.4          Major noise sources during the monitoring included construction noise from the Project site and nearby traffic noise.

5.3          Waste Management

5.3.1          C&D materials and wastes sorting were carried out on site. Receptacles were available for C&D wastes and general refuse collection.

5.3.2          As advised by the Contractor, 2,516 m3 of C&D material were generated and no C&D material was disposed to public fill. 1,992 m3 and 525 m3 of inert C&D were reused in the contract and other projects in the reporting month respectively. 86,380 kg of general refuse was generated and sent to NENT Landfill in the reporting month. No metal, no plastics and no paper/cardboard packaging were collected by recycle contractor in the reporting month. No chemical waste was collected by licensed contractor in the reporting month. No Type 1, Type 2 and Type 3 Marine sediment were disposed at Confined Marine Disposal Facility to the East of Sha Chau. The waste flow table is annexed in Appendix K.

5.3.3          The Contractor is advised to properly maintain on site C&D materials and wastes collection, sorting and recording system and maximize reuse / recycle of C&D materials and wastes. The Contractor is reminded to properly maintain the site tidiness and dispose of the wastes accumulated on site regularly and properly.

5.3.4          The Contractor is reminded that chemical waste containers should be properly treated and stored temporarily in designated chemical waste storage area on site in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes.

5.3.5          According to the Contractor’s information, the concerned soil, which assessed under the updated Supplementary Contamination Assessment Report, approximately 54.3 m3 of contaminated soil was backfilled in MTK C&C tunnel on 5 November 2024. In order to minimize the potentially adverse environmental impacts arising for the handling of potentially contaminated materials, the following environmental mitigation measures are proposed during the course soil backfilling works:

·      Regular site audit will be conducted under the Environmental Monitoring and Audit (EM&A) programme to ensure the soil backfilling works are carried out in accordance with this report.  Findings of the site audit will be presented in Table 6.1.

·      The truck transferring Concerned Soil shall be covered entirely by impervious sheeting to ensure that the dusty materials do not leak from the truck.

5.4          Landscape and Visual

5.4.1          Bi-weekly inspection of the implementation of landscape and visual mitigation measures was conducted on 13 and 27 November 2024. A summary of the site inspection is provided in Appendix C. The observations and recommendations made during the site inspections are presented in Table 6.1.

6              ENVIRONMENTAL SITE INSPECTION AND AUDIT

6.1.1          Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures for the Project. A summary of the mitigation measures implementation schedule is provided in Appendix C.

6.1.2          In the reporting month, 4 site inspections were carried out on 6, 13, 20 and 27 November 2024. Joint inspections with the IEC, ER, the Contractor and ET were conducted on 20 and 27 November 2024. No non-compliance was recorded during the site inspection. Details of observations recorded during the site inspections are presented in Table 6.1.

Table 6.1         Observations and Recommendations of Site Audit

Parameters

Date

Observations and Recommendations

Follow-up

Air Quality

6 November 2024

Reminder:

The contractor was reminded to provide watering at MTK site regularly.

The item was rectified by the Contractor on
6 November 2024.

Noise

Nil

Nil

Nil

Water Quality

20 November 2024

Observation:

The silt curtain was observed not fully enclosed at Kai Tak Promenade. The Contractor should ensure the silt curtain was fully enclosed to prevent marine pullution.

The item was rectified by the Contractor on
21 November 2024.

Waste/ Chemical Management

20 November 2024

Reminder:

The Contractor was reminded to provide dirp tray for the chemical container at Stage 2 marine platform.

The item was rectified by the Contractor on
26 November 2024.

27 November 2024

Reminder:

The Contractor was reminded to provide a cover for the general refuse container at Stage 2 marine platform.

The item was rectified by the Contractor on
4 December 2024.

Landscape

& Visual

Nil

Nil

Nil

Permits/

Licenses

Nil

Nil

Nil

*The item was under rectification on last reporting month.

6.1.3          All follow-up actions requested by Contractor's ET during the site inspection were undertaken as reported by the Contractor and confirmed in the following weekly site inspection conducted during the reporting period.

7              Environmental Non-conformance

7.1          Summary of Monitoring Exceedances

7.1.1          All 24-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.

7.1.2          All 1-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.

7.1.3          No exceedance of Action and Limit level of noise was recorded in the reporting month.

7.2          Summary of Environmental Non-Compliance

7.2.1          No environmental non-compliance was recorded in the reporting month.

7.3          Summary of Environmental Complaints

7.3.1          One (1) complaint was received in the reporting month November 2024) and the investigation was conducted in the current reporting month (November 2024). Cumulative statistics on environmental complaint is provided in Appendix J.

7.4          Summary of Environmental Summon and Successful Prosecutions

7.4.1          No environmental related prosecution or notification of summons was received in the reporting month. Cumulative statistics on notification of summons and successful prosecutions is provided in Appendix J.

8              FUTURE KEY ISSUES

8.1          Construction Programme for the Next Three Months

8.1.1          The major construction works between December 2024 to February 2025 are provided in Table 8.1.

Table 8.1          Construction Activities in the coming three months

Locations

Site Activities

Kai Tak

- Defect rectification works at underpass, depressed road and C&C
- Channel construction at the roof of ventilation adit

Ma Tau Kok

- TTM implementation;
- Asphalt paving at MTK C&C Tunnel;
- Dismantel of MTK Traffic Deck;
- Drainage Construction in MTK.

Kowloon Bay

- Removal of Excavation and Lateral Support (ELS) at Stage 2 UWT;
- Backfilling at Stage 2 UWT;
- Asphalt paving at Stage 2 UWT;
- Dismantle of Temporary Stage 2 Marine Platform;
- MTK seawall reinstatement;
- Re-construction of Ma Tau Kok Public Pier

8.2          Key Issues for the Coming Month

8.2.1          Potential environmental impacts arising from the above construction activities are mainly associated with construction dust, construction noise, and waste management.

8.3          Monitoring Schedule for the Coming Month

8.3.1          The tentative schedule for environmental monitoring in December 2024 is provided in Appendix F.

9              ConclusionS AND RECOMMENDATIONS

9.1          Conclusions

9.1.1          1-hour TSP, 24-hour TSP and noise monitoring were carried out in the reporting month.

9.1.2          All 24-hour TSP monitoring results complied with the Action / Limit Level at in the reporting month.

9.1.3          All 1-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.

9.1.4          No exceedance of Action and Limit level of noise was recorded in the reporting month.

9.1.5          4 nos. of environmental site inspections were carried out in November 2024. Recommendations on remedial actions were given by ET and IEC to the Contractor for the deficiencies identified during the site audit.

9.1.6          One (1) complaint was received in the reporting month (November 2024) and the investigation was conducted in the current reporting month (November 2024).

9.1.7          No environmental related notification of summons and successful prosecution were received in the reporting month.

9.2          Recommendations

9.2.1          According to the environmental site inspections performed in the reporting month, the following recommendations were provided:

Air Quality Impact

·      The contractor was reminded to provide watering at MTK site regularly.

Construction Noise Impact

·      No specific observation was identified in the reporting month.

Water Quality Impact

·      The Contractor was advised to ensure the silt curtain was fully enclosed to prevent marine pollution.

Chemical and Waste Management

·      The Contractor was reminded to provide dirp tray for the chemical container at Stage 2 marine platform.

·      The Contractor was reminded to provide a cover for the general refuse container at Stage 2 marine platform.

Landscape & Visual Impact

·      No specific observation was identified in the reporting month.

Permits/licenses

·      No specific observation was identified in the reporting month.

A close-up of a white background

Description automatically generated

A close-up of a document

Description automatically generated

A close-up of a document

Description automatically generated

Document control record

Document prepared by:

Aurecon Hong Kong Limited

Unit 1608, 16/F, Tower B,

Manulife Financial Centre

223 -231 Wai Yip Street, Kwun Tong, Kowloon, Hong Kong.

T
F
E
W

3664 6888
3664 6999
hongkong@aurecongroup.com
www.aurecongroup.com

A person using Aurecon documents or data accepts the risk of:

a)       Using the documents or data in electronic form without requesting and checking them for accuracy

b)       Using the documents or data for any purpose not agreed to in writing by Aurecon.

c)       against the original hard copy version.

A screenshot of a computer

Description automatically generated

Contents

Executive Summary. 2

1   Introduction. 4

2   Environmental Status. 7

3   Air Quality and Noise Monitoring. 8

4   Waste Management 10

5   Landscape and Visual 11

6   Summary of Complaints, Notification of Summons and Prosecutions. 12

7   EM&A Site Inspection. 14

8   Future Key Issues. 15

9   Conclusion and Recommendations. 16

Appendices

Appendix A        Alignment and Works Site in Kai Tak West Area for the Contract No. HY/2023/08

Appendix B        Construction Programme

Appendix C        Project Organization Chart

Appendix D         Event and Action Plan (EAP) (Air Quality Monitoring)

Appendix E        Event and Action Plan (EAP) (Noise Monitoring)

Appendix F         Environmental Mitigation Implementation Schedule (EMIS)

Appendix G         Waste Flow Table

Appendix H         Statistics on Complaint, Notifications of Summons and Successful Prosecutions

Executive Summary

1.1.1          Build King - Lee Tung Joint Venture (“Contractor”) commenced the construction works of Highway Department (HyD) Central Kowloon Route Contract No. HY/2023/08 – Central Kowloon Route – Remaining Works at Kai Tak West Area (“The Project”) on 11 November 2024.  This is the 1st monthly Environmental Monitoring and Audit (EM&A) report presenting the EM&A works carried out in the Kai Tak West Area during the period from 11 November 2024 to 30 November 2024.

1.1.2          A summary of major construction activities informed by the Contractor for the Project during the reporting period is presented below.

Construction Activities Undertaken in Kai Tak West Area

·         Site preparation and access set up for Part of Site 4C at Kai Tak Phase 2B Landscape Deck

Environmental Monitoring and Audit Works

1.1.3          Regular construction air quality monitoring (24-hour TSP and 1-hour TSP) and noise monitoring works in Kai Tak West Area are currently covered under the Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West.  The details of the monitoring works could be referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.

1.1.4          Joint weekly site inspections were conducted by representatives of the Environmental team (ET), the Contractor and the Engineer on 15, 22 and 29 November 2024. A joint site inspection with the Independent Environmental Checker (IEC) was undertaken on 15 November 2024.  Bi-weekly inspection of the implementation of landscape and visual mitigation measures was conducted by the ET on 15 and 29 November 2024. Details of the audit findings and implementation status are presented in Section 7.  Details of waste management are presented in Section 4.

1.1.5          A summary of the non-compliance (exceedance) during the reporting period is provided below.

-          No Action / Limit Level exceedance for 1-hour TSP was recorded.

-          No Action / Limit Level exceedance for 24-hour TSP was recorded.

-          No Action / Limit Level exceedance for construction noise was recorded.

Complaints, Notification of Summons and Successful Prosecution

1.1.6          No environmental related complaints, notification of summons and successful prosecution were received in the reporting period.

Reporting Changes

1.1.7          There were no reporting changes during the reporting period.

Future Key Issues

1.1.8         A summary of construction activities informed by the Contractor for the next reporting period are listed below:

Construction Activities Undertaken in Kai Tak West Area

·         To complete site preparation works and site survey at Kai Tak Phase 2B Landscaped Deck

1      Introduction

1.1 Basic Project Information

1.1.1          Central Kowloon Route (CKR) is a 4.7 km long dual 3-lane trunk road in Central Kowloon linking Yau Ma Tei Interchange in West Kowloon with the road network on Kai Tak Development and Kowloon Bay in East Kowloon.

1.1.2          The Central Kowloon Route – Design and Construction Environmental Impact Assessment Report (Register No.: AEIAR-171/2013) was approved with conditions by the Environmental Protection Department (EPD) on 11 July 2013. An Environmental Permit (EP 457/2013) was issued on 9 August 2013.  Variations of EP (VEP) was subsequently applied for and the latest EP (EP-457/2013/D) was issued by EPD on 15 June 2021.

1.1.3          The construction of the CKR had been divided into different sections.  Contract No. HY/2023/08 – Central Kowloon Route – Remaining Works covers part of the construction activities located at Kai Tak West Area and Yau Ma Tei Area under the EP, including:

1.1.4          The works site at Kai Tak West Area for the Contract No. HY/2023/08 are shown in Appendix A.

1.2 Purpose of the Report

1.2.1          This is the 1st monthly Environmental Monitoring and Audit (EM&A) report presenting the EM&A works carried out for the Project in the Kai Tak West Area during the period from 11 November 2024 to 30 November 2024.

1.3 Construction Activities Undertaken During the Reporting Period

1.3.1          A summary of major construction activities carried out during the reporting period are presented in Table 1.1.  The construction programme is presented in Appendix B.

Table 1.1    Summary of Construction Activities during the Reporting Period

Construction Activities Undertaken in Kai Tak West Area

Progress

·         Site preparation and access set up for Part of Site 4C at Kai Tak Phase 2B Landscaped Deck

10%

1.4 Project Organisation

1.4.1          The project organization structure is shown in Appendix C. The key personnel contact names and numbers for the Project are summarized in Table 1.2.

Table 1.2              Contact Information of Key Personnel

Party

Role

Position

Name

Contact No.

Arup – Mott MacDonald Joint Venture

Engineer’s Representative (“ER”)

Resident Engineer (Environmental)

Ms. Jim Li

9120 1157

ERM – Hong Long Limited

Independent Environmental Checker (“IEC”)

IEC

Ms. Mandy To

2271 3313

Aurecon Hong Kong Limited

Environmental Team (“ET”)

ET Leader

Mr. F. C. Tsang

2698 6833

Build King – Tung Lee Joint Venture

Contractor

Environmental Officer

Mr. Samuel Pang

9876 9121

1.5 Status of Environmental Licences, Notification and Permit

1.5.1         A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.3.

Table 1.3    Summary of the Environmental Licence, Notification, Permit and Documentations

Permit/ License/ Notification / Reference No.

Valid Period

Status

Remark

From

To

Environmental Permit

EP-457/2013/D

15 June 2021

--

Valid

--

Wastewater Discharge License

--

--

--

To be applied

--

Notification of Construction Works Under the Air Pollution Control (Construction Dust Regulation)

10007346

--

--

Application submitted on 25 July 2024

--

Chemical Waste Producer Registration

5213-252-B2767-01

14 August 2024

--

Valid

--

Billing Account for Disposal of Construction Waste

7051793

6 August 2024

--

Valid

--

Y-Park Membership

C0280

12 August 2024

--

Valid

--

Construction Nosie Permit

2142643

--

--

Application submitted on 18 Nov 2024

General Activities at Kai Tak Phase 2B Landscaped Deck

2      Environmental Status

2.1 Environmental Permit (EP) Submission Status

2.2    Environmental permit (EP) conditions under the EIAO, submission status under the EP and implementation status of mitigation measures had been reviewed and implemented on schedule. The status of required submissions under the EP (EP-457/2013/D) as of the reporting period for the Project are summarised in Table 2.1.

Table 2.1  Summary of Status of Required Submission for EP-457/2013/D for the Project

EP Condition
 (EP – 457/2013/D)

Submission

Submission Date

1.12

Notification of Commencement Date of Construction of Project

11 September 2024

2.3

Community Liaison Group

Covered by other Contracts

2.4

Management Organization of the main construction companies

11 September 2024

2.5

Construction Programme and EPD Submission Schedule

11 September 2024

2.6

Design Drawing

11 September 2024

2.8

Landscape Mitigation Plan (LMP)

(Version 1)

11 September 2024

2.9

Construction Noise Mitigation Plan (CNMMP) (Version 1)

11 September 2024

3.3

Baseline Monitoring Report

(1)

Notes:

(1)  The Baseline Monitoring Report for Contract No. HY/2014/07 Kai Tak West will be adopted for the Kai Tak West Area of this Project.

3      Air Quality and Noise Monitoring

3.1 Air Quality

Monitoring Requirements and Results

3.1.1          As the air quality (24-hour TSP, 1-hour TSP) monitoring works in Kai Tak West Area are currently covered under Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West.  The details of the corresponding monitoring parameters, equipment, methodology, monitoring schedule wind data, results and the established Action and Limit Levels could be referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.

Observations

3.1.2          No Action/Limit Level exceedance was recorded for all 1-hour TSP and 24-hour TSP monitoring in the reporting period.

3.1.3         Site audits were carried out on a weekly basis to monitor and audit the timely implementation of air quality mitigation measures within the site boundaries of this Project.  A summary of observation during the site audits is shown in Table 7.1 of this report.

3.2 Noise

Monitoring Requirements and Results

3.2.1          As the construction noise monitoring works in Kai Tak West Area are currently covered under Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West.  The details of the corresponding monitoring parameters, equipment, methodology, results and the established Action and Limit Levels could be referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.

Observations

3.2.2          No Action/Limit Level exceedance was recorded for construction noise monitoring in the reporting period.

3.2.3          Site audits were carried out on a weekly basis to monitor and audit the timely implementation of noise mitigation measures within the site boundaries of this Project.  A summary of observations during the site audits is shown in Table 7.1 of this report.

4      Waste Management

4.1.1          Waste generated from this Project includes inert C&D materials and non-inert C&D materials. Non-inert C&D materials are made up of general refuse, vegetative wastes and recyclable wastes such as plastics and paper/cardboard packaging waste. Steel materials generated from the project are also grouped into non-inert C&D materials as the materials were not disposed of with other inert C&D materials. As advised by the Contractor, no inert C&D materials, non-inert C&D materials nor chemical waste was generated and disposed of during this reporting period.

4.1.2         With reference to relevant handling records and trip tickets of this Project, the quantities of different types of waste generated in the reporting period are summarised in Table 4.1. Details of cumulative waste management data are presented as a waste flow table in Appendix G.

Table 4.1  Quantities of Waste Generated from the Project in the Reporting Period

Reporting

period

Quantity

Inert C&D Materials

(in ‘000 kg)

Chemical Waste

(in ‘kg)

Non-inert C&D Materials

 Others, e.g. General Refuse disposed at Landfill

(in ‘000kg)

Recycled materials

Paper/

cardboard

(in ‘000kg)

Plastics

(in ‘000 kg)

Metals

(in ‘000 kg)

Nov 2024
(11 - 30 Nov 2024)

0.00

0.00

0.00

0.00

0.00

0.00

5      Landscape and Visual

5.1.1          As per the EM&A Manuals, the landscape and visual mitigation measures shall be implemented, and site inspections should be undertaken once every two weeks during the construction period.

5.1.2          Bi-weekly inspection of the implementation of landscape and visual mitigation measures was conducted on 15 and 29 November 2024. The observations and recommendations made during the site inspections are presented in Table 7.1.    A summary of the implementation status is presented in Appendix F.

6      Summary of Complaints, Notification of Summons and Prosecutions

6.1.1           The environmental Complaints Handling Procedures is shown in below.

Complaint Received via Project Hotline

Complaint Received via 1823 or from other government departments

Contractor notify ER, ET and IEC

ER notify Contractor, ET and IEC

Contractor log complaint and date of receipt onto the complaint database. Contractor, ER and ET to conduct investigation of complaint

If complaint is considered not valid

If complaint is found valid

ET or ER to reply the complainant if necessary

Contractor to identify and implement remedial measures in consultation with the IEC, ET and ER.

The ER, ET and IEC to review the effectiveness of the Contractor’s remedial measures and the updated situation; ET to undertake additional monitoring and audit to verify the situation if necessary and oversee that circumstances leading to the complaint do not recur. ER to conduct further inspection as necessary.

 If the complaint is referred by the EPD, the Contractor to prepare interim report on the status of the complaint investigation and follow-up actions stipulated above, including the details of the remedial measures and additional monitoring identified or already taken, for submission to EPD within the time frame assigned by the EPD.

The ET to record the details of the complaint, results of the investigation, subsequent actions taken to address the complaint and updated situation including the effectiveness of the remedial measures, supported by regular and additional monitoring results in the monthly EM&A reports.

6.1.2          Should non-compliance of the criteria occur, action in accordance with the Event and Action Plan in Appendix D and Appendix E shall be carried out.

6.1.3          No exceedance of the Action and Limit Levels of air quality (1-hour TSP and 24-hour TSP) monitoring and noise monitoring was recorded in the reporting period.

6.1.4          No complaint was received in the reporting period.

6.1.5          No non-compliance was received in the reporting period.

6.1.6          No notification of summons and successful prosecution was received in the reporting period.

6.1.7          Statistics on complaints, notifications of summons and successful prosecutions are summarized in Appendix H.

7      EM&A Site Inspection

7.1.1          Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. In the reporting period, 3 site inspections were carried out by the representative of ET, Contractor and Engineer on 15, 22 and 29 November 2024, along with bi-weekly inspection of the implementation of landscape and visual mitigation measures conducted on 15 and 29 November 2024.

7.1.2          One joint site inspection with the IEC was also undertaken on 15 September 2024. No deficiencies were observed during weekly site inspection. Key observations during the site inspections are summarized in Table 7.1.

Table 7.1  Summary of Site Observation

Date

Environmental Observations

Follow-up Status

15 November 2024

Nil.

Nil.

22 November 2024

Nil.

Nil.

29 November 2024

Nil.

Nil.

7.1.3          No observation was identified during the environmental site inspection in the reporting period.

7.1.4          According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents had been implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix F.

8      Future Key Issues

8.1.1         The construction activities to be undertaken in the next reporting period are listed below:

Construction Activities Undertaken in Kai Tak West Area

·         To complete site preparation works and site survey at Kai Tak Phase 2B Landscaped Deck

8.1.2          Potential environmental impacts arising from the above construction activities are mainly associated with dust and waste management.

8.1.3          The tentative schedule of air quality (1-hour TSP and 24-hour TSP) monitoring and noise monitoring in the next reporting period is presented in Appendix F of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.

8.1.4          The construction programme for the Project for the next reporting period is presented in Appendix B.

9      Conclusion and Recommendations

9.1.1          This is the 1st monthly EM&A Report presents the EM&A works undertaken in Kai Tak West Area during the period from 11 November 2024 to 30 November 2024 in accordance with the EM&A Manual and the requirement under EP-457/2013/D.

9.1.2          Air quality monitoring (including 1-hour TSP and 24-hour TSP) and noise monitoring were carried out in the reporting period under Contractor No. HY/2014/07.  No exceedance of the Action and Limit Level was recorded for air quality monitoring and noise during the reporting period.

9.1.3          Weekly environmental site inspections by the representative of ET, Contractor and Engineer were conducted during the reporting period. One joint site inspection with the IEC was carried out on 15 November 2024.  No observation was identified during the reporting period. The environmental performance of the Project was therefore considered satisfactory.

9.1.4          No complaint was received in the reporting period.

9.1.5          No non-compliance situation was received in the reporting period.

9.1.6          No notification of summons or prosecution was received since commencement of the Contract.

9.1.7          The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.

Appendix A

Alignment and Works Site in Kai Tak West Area for the Contract No. HY/2023/08

Kai Tak Phase 2B Landscaped Deck

A diagram of a person's figure

Description automatically generated

Appendix B

Construction Programme

A screenshot of a computer screen

Description automatically generated

Appendix C

Project Organisation Chart

TSANG Fan Cheong

Tel.: 3664 6801

A diagram of a workflow

Description automatically generated

Appendix D

Event and Action plan (EAP) (Air Quality Monitoring)

EVENT

ACTION

ENVIRONMENTAL TEAM (ET)

INDEPENDENT ENVIRONMENTAL CHECKER (IEC)

ENGINEER’S REPRESENTATIVE ER

CONTRACTOR

ACTION LEVEL

Exceedance for one sample

1. Identify source, investigate the causes of exceedance and propose remedial measures;

2. Inform IEC and ER;

3. Repeat measurement to confirm finding;

4. Increase monitoring frequency to daily.

1. Check monitoring data submitted by ET;

2. Check Contractor’s working method.

1. Notify Contractor.

1. Rectify any unacceptable practice;

2. Amend working methods if appropriate.

Exceedance for two or more consecutive samples

1. Identify source;

2. Inform IEC and ER;

3. Advise the ER on the effectiveness of the proposed remedial measures;

4. Repeat measurements to confirm findings;

5. Increase monitoring frequency to daily;

6. Discuss with IEC and Contractor on remedial actions required;

7. If exceedance continues, arrange meeting with IEC and ER;

8. If exceedance stops, cease additional monitoring.

1. Check monitoring data submitted by ET;

2. Check Contractor’s working method;

3. Discuss with ET and Contractor on possible remedial measures;

4. Advise the ET on the effectiveness of the proposed remedial measures;

5. Supervise Implementation of remedial measures.

1. Confirm receipt of notification of failure in writing;

2. Notify Contractor;

3. Ensure remedial measures properly implemented.

1. Submit proposals for remedial to ER within 3 working days of notification;

2. Implement the agreed proposals;

3. Amend proposal if appropriate.

LIMIT LEVEL

Exceedance for one sample

1. Identify source, investigate the causes of exceedance and propose remedial measures;

2. Inform ER, Contractor and EPD;

3. Repeat measurement to confirm finding;

4. Increase monitoring frequency to daily;

5. Assess effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER informed of the results.

1. Check monitoring data submitted by ET;

2. Check Contractor’s working method;

3. Discuss with ET and Contractor on possible remedial measures;

4. Advise the ER on the effectiveness of the proposed remedial measures;

5. Supervise implementation of remedial measures.

1. Confirm receipt of notification of failure in writing;

2. Notify Contractor;

3. Ensure remedial measures properly implemented.

1. Take immediate action to avoid further exceedance;

2. Submit proposals for remedial actions to IEC within 3 working days of notification;

3. Implement the agreed proposals;

4. Amend proposal if appropriate.

Exceedance for two or more consecutive samples

1.Notify IEC, ER, Contractor and EPD;

2. Identify source;

3. Repeat measurement to confirm findings;

4. Increase monitoring frequency to daily;

5. Carry out analysis of Contractor’s working procedures to determine possible mitigation to be implemented;

6. Arrange meeting with IEC and ER to discuss the remedial actions to be taken;

7. Assess effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER informed of the results;

8. If exceedance stops, cease additional monitoring.

1. Discuss amongst ER, ET, and Contractor on the potential remedial actions;

2. Review Contractor’s remedial actions whenever necessary to assure their effectiveness and advise the ER accordingly;

3. Supervise the implementation of remedial measures.

1. Confirm receipt of notification of failure in writing;

2. Notify Contractor;

3. In consultation with the IEC, agree with the Contractor on the remedial measures to be implemented;

4. Ensure remedial measures properly implemented;

5. If exceedance continues, consider what portion of the work is responsible and instruct the Contractor to stop that portion of work until the exceedance is abated.

1. Take immediate action to avoid further exceedance;

2. Submit proposals for remedial actions to IEC within 3 working days of notification;

3. Implement the agreed proposals;

4. Resubmit proposals if problem still not under control;

5. Stop the relevant portion of works as determined by the ER until the exceedance is abated.

Appendix E

Event and Action plan (EAP) (Noise Monitoring)

EVENT

ACTION

ENVIRONMENTAL TEAM (ET)

INDEPENDENT ENVIRONMENTAL CHECKER (IEC)

ENGINEER’S REPRESENTATIVE ER

CONTRACTOR

Action Level

1. Identify source, investigate the causes of exceedance and propose remedial measures;

2. Notify IEC and Contractor;

3. Report the results of investigation to the IEC, ER and Contractor;

4. Discuss with the Contractor and formulate remedial measures;

5. Increase monitoring frequency to check mitigation effectiveness.

1. Review the analysed results submitted by the ET;

2. Review the proposed remedial measures by the Contractor and advise the ER accordingly;

3. Supervise the implementation of remedial measures.

1. Confirm receipt of notification of failure in writing;

2. Notify Contractor;

3. Require Contractor to propose remedial measures for the analysed noise problem;

4. Ensure remedial measures are properly implemented

1. Submit noise mitigation proposals to IEC;

2. Implement noise mitigation proposals.

Appendix F

Environmental Mitigation Implementation Schedule (EMIS)

Environmental Mitigation Implementation Schedule

EIA Ref.

EM&A Log Ref.

Recommended Mitigation Measures

Objectives of the Recommended Measures & Main Concerns to address

Implementation Agent

Location / Timing

Implementation Stage

Requirements and/ or standards to be achieved

Implementation Status

Construction Dust Impact

S4.3.10

D1

The contractor shall follow the procedures and requirements given in the Air Pollution Control (Construction Dust) Regulation and Air Pollution Control (Non-road Mobile Machinery) (Emission) Regulation.

Minimize dust impact and adverse health effects at the nearby sensitive receivers

Contractor

All construction sites

Construction stage

·    APCO

·    To control the dust impact to meet HKAQO and TM-EIA criteria

N/A

S4.3.10

D2

·   Mitigation measures in form of regular watering under a good site practice should be adopted.  Watering once per hour on exposed worksites and haul road should be conducted to achieve dust removal efficiencies of 91.7%. While the above watering frequencies are to be followed, the extent of watering may vary depending on actual site conditions but should be sufficient to maintain an equivalent intensity of no less than 1.3 L/m2 to achieve the dust removal efficiency.

Minimize dust impact at the nearby sensitive receivers

Contractor

All construction sites

Construction stage

·   APCO

·   To control the dust impact to meet HKAQO and TM-EIA criteria

N/A

xS4.3.10

D3

·       Proper watering at exposed spoil should be undertaken throughout the construction phase;

·       Any excavated or stockpile of dusty material should be covered entirely by impervious sheeting or sprayed with water to maintain the entire surface wet and then removed or backfilled or reinstated where practicable within 24 hours of the excavation or unloading;

·       Any dusty materials remaining after a stockpile is removed should be wetted with water and cleared from the surface of roads;

·       A stockpile of dusty material should not be extended beyond the pedestrian barriers, fencing or traffic cones;

·       The load of dusty materials on a vehicle leaving a construction site should be covered entirely by impervious sheeting to ensure that the dusty materials do not leak from the vehicle.

·       Where practicable, vehicle washing facilities with high pressure water jet should be provided at every discernible or designated vehicle exit point.  The area where vehicle washing takes place and the road section between the washing facilities and the exit point should be paved with concrete, bituminous materials or hardcores;

·       When there are open excavation and reinstatement works, hoarding of not less than 2.4m high should be provided and properly maintained as far as practicable along the site boundary with provision for public crossing.  Good site practice shall also be adopted by the Contractor to ensure the conditions of the hoardings are properly maintained throughout the construction period;

·       The portion of any road leading only to construction site that is within 30m of a vehicle entrance or exit should be kept clear of dusty materials;

·       Surfaces where any pneumatic or power-driven drilling, cutting, polishing or other mechanical breaking operation takes place should be sprayed with water or a dust suppression chemical continuously;

·       Any area that involves demolition activities should be sprayed with water or a dust suppression chemical immediately prior to, during and immediately after the activities so as to maintain the entire surface wet;

·       Any skip hoist for material transport should be totally enclosed by impervious sheeting;

·       Every stock of more than 20 bags of cement or dry-pulverised fuel ash (PFA) should be covered entirely by impervious sheeting or placed in an area sheltered on the top and the 3 sides;

·       Loading, unloading, transfer, handling or storage of bulk cement or dry PFA should be carried out in a totally enclosed system or facility, and any vent or exhaust should be fitted with an effective fabric filter or equivalent air pollution control system

·       Exposed earth should be properly treated by compaction, turfing, hydroseeding, vegetation planting or sealing with latex, vinyl, bitumen, shotcrete or other suitable surface stabilizer within six months after the last construction activity on the construction site or part of the construction site where the exposed earth lies.

Minimize dust impact at the nearby sensitive receivers

Contractor

All construction sites

Construction stage

·   APCO

·   To control the dust impact to meet HKAQO and TM-EIA criteria

N/A

S4.3.10

D6

Implement regular dust monitoring under EM&A programme during the construction stage.

Monitoring of dust impact

Contractor

Selected rep. dust monitoring station

Construction stage

·   TM-EIA

10       Implemented

11   Construction Noise (Airborne)

S5.4.1

N1

Implement the following good site practices:

·   Only well-maintained plant should be operated on-site, and plant should be serviced regularly during the construction programme;

·   Machines and plant (such as trucks, cranes) that may be in intermittent use should be shut down between work periods or should be throttled down to a minimum;

·   Plant known to emit noise strongly in one direction, where possible, be orientated so that the noise is directed away from nearby NSRs;

·   Silencers or mufflers on construction equipment should be properly fitted and maintained during the construction works;

·   Mobile plant should be sited as far away from NSRs as possible and practicable;

·   Material stockpiles, mobile container site office and other structures should be effectively utilized, where practicable, to screen noise from on-site construction activities.

Control construction airborne noise

Contractor

All construction sites

Construction stage

·   Annex 5, TM-EIAO

N/A

S5.4.1

N2

Install temporary hoarding located on the site boundaries between noisy construction activities and NSRs.  The conditions of hoardings shall be properly maintained throughout the construction period.

12       Reduce the construction noise levels at low-level zone of NSRs through partial screening

13       Contractor

14       All construction sites

15       Construction stage

·   Annex 5, TM-EIAO

16       Implemented

S5.4.1

N3

Install movable noise barriers (typical design is wooden framed barrier with a small-cantilevered on a skid footing with 25mm thick internal sound absorptive lining), acoustic mat or full enclosure, screen the noisy plants including air compressors, generators and handheld breakers, etc.

17       Screen the noisy plant items to be used at all construction sites

18       Contractor

19       All construction sites where practicable

20       Construction stage

·   Annex 5, TM-EIAO

21       N/A

S5.4.1

N4

Use ‘Quiet plant’

22       Reduce the noise levels of plant items

23       Contractor

24       All construction sites where practicable

25       Construction stage

·   Annex 5, TM-EIAO

26       N/A

S5.4.1

N5

Loading/ unloading activities should be carried out inside the full enclosure of mucking out points.

27       Reduce the noise levels of loading/ unloading activities

28       Contractor

29       Mucking out locations

30       Construction stage

·   Annex 5, TM-EIAO

31       N/A

S5.4.1

N6

Sequencing operation of construction plants where practicable.

32       Operate sequentially within the same work site to reduce the construction airborne noise

33       Contractor

34       All construction sites where practicable

35       Construction stage

·   Annex 5, TM-EIAO

36       N/A

S5.4.1

N7

Implement a noise monitoring programme under EM&A programme.

37       Monitor the construction noise levels at the selected representative locations

38       Contractor

39       Selected rep. noise monitoring station

40       Construction stage

·   TM-EIAO

41       N/A

42   Water Quality (Construction Phase)

S6.9.1.1

W1

In accordance with the Practice Note for Professional Persons on Construction Site Drainage, Environmental Protection Department, 2023 (ProPECC PN 2/23), construction phase mitigation measures shall include the following:

Construction Runoff

·   At the start of site establishment, perimeter cut-off drains to direct off-site water around the site should be constructed with internal drainage works and erosion and sedimentation control facilities implemented.  Channels (both temporary and permanent drainage pipes and culverts), earth bunds or sandbag barriers should be provided on site to direct stormwater to silt removal facilities.  The design of the temporary on-site drainage system will be undertaken by the contractor prior to the commencement of construction;

·   The dikes or embankments for flood protection should be implemented around the boundaries of earthwork areas.  Temporary ditches should be provided to facilitate the runoff discharge into an appropriate watercourse, through a silt/ sediment trap.  The sediment/ silt traps should be incorporated in the permanent drainage channels to enhance deposition rates;

·   The design of efficient silt removal facilities should be based on the guidelines in Appendix A1 of ProPECC PN 2/23, which states that the retention time for silt/ sand traps should be 5 minutes under maximum flow conditions.  Sizes may vary depending upon the flow rate, but for a flow rate of 0.1 m3/s a sedimentation basin of 30 m3 would be required and for a flow rate of 0.5 m3/s the basin would be 150 m3.  The detailed design of the sand/ silt traps shall be undertaken by the contractor prior to the commencement of construction;

·   All exposed earth areas should be completed and vegetated as soon as possible after earthworks have been completed, or alternatively, within 14 days of the cessation of earthworks where practicable.  Exposed slope surfaces should be covered by tarpaulin or other means;

·   The overall slope of the site should be kept to a minimum to reduce the erosive potential of surface water flows, and all traffic areas and access roads protected by coarse stone ballast.  An additional advantage accruing from the use of crushed stone is the positive traction gained during prolonged periods of inclement weather and the reduction of surface sheet flows;

·   All drainage facilities and erosion and sediment control structures should be regularly inspected and maintained to ensure proper and efficient operation at all times and particularly following rainstorms.  Deposited silt and grit should be removed regularly and disposed of by spreading evenly over stable, vegetated areas;

·   Measures should be taken to minimize the ingress of site drainage into excavations.  If the excavation of trenches in wet periods is necessary, they should be dug and backfilled in short sections wherever practicable.  Water pumped out from trenches or foundation excavations should be discharged into storm drains via silt removal facilities;

·   Open stockpiles of construction materials (for example, aggregates, sand and fill material) of more than 50m3 should be covered with tarpaulin or similar fabric during rainstorms.  Measures should be taken to prevent the washing away of construction materials, soil, silt or debris into any drainage system;

·   Manholes should always be adequately covered and temporarily sealed so as to prevent silt, construction materials or debris being washed into the drainage system and storm runoff being directed into foul sewers;

·   Precautions be taken at any time of year when rainstorms are likely, actions to be taken when a rainstorm is imminent or forecasted, and actions to be taken during or after rainstorms are summarized in Appendix A2 of ProPECC PN 2/23.  Particular attention should be paid to the control of silty surface runoff during storm events, especially for areas located near steep slopes;

·   All vehicles and plant should be cleaned before leaving a construction site to ensure no earth, mud, debris and the like is deposited by them on roads.  An adequately designed and site wheel washing facilities should be provided at every construction site exit where practicable.  Wash-water should have sand and silt settled out and removed at least on a weekly basis to ensure the continued efficiency of the process.  The section of access road leading to, and exiting from, the wheel wash bay to the public road should be paved with sufficient backfall toward the wheel wash bay to prevent vehicle tracking of soil and silty water to public roads and drains;

·   Oil interceptors should be provided in the drainage system downstream of any oil/ fuel pollution sources.  The oil interceptors should be emptied and cleaned regularly to prevent the release of oil and grease into the storm water drainage system after accidental spillage.  A bypass should be provided for the oil interceptors to prevent flushing during heavy rain;

·   Construction solid waste, debris and rubbish on site should be collected, handled and disposed of properly to avoid water quality impacts;

·   All fuel tanks and storage areas should be provided with locks and sited on sealed areas, within bunds of a capacity equal to 110% of the storage capacity of the largest tank to prevent spilled fuel oils from reaching water sensitive receivers nearby;

·   Adopt best management practices;

·   All earth works should be conducted sequentially to limit the amount of construction runoff generated from exposed areas during the wet season (April to September) as far as practicable.

43       To minimize water quality impact from the construction site runoff and general construction activities

44       Contractor

45       All construction sites where practicable

46       Construction stage

·   Water Pollution Control Ordinance

·   ProPECC PN 2/23

·   TM-EIAO

·   TM-DSS

47       Implemented

S6.9.1.2

W2

Tunnelling Works and Underground Works

·   Cut-&-cover tunnelling work should be conducted sequentially to limit the amount of construction runoff generated from exposed areas during the wet season (April to September) as far as practicable.

·   Uncontaminated discharge should pass through sedimentation tanks prior to off-site discharge;

·   The wastewater with a high concentration of SS should be treated (e.g. by sedimentation tanks with sufficient retention time) before discharge.  Oil interceptors would also be required to remove oil, lubricants and grease from the wastewater;

·   Direct discharge of the bentonite slurry (as a result of D-wall) is not allowed.  It should be reconditioned and reused wherever practicable.  Temporary storage locations (typically a properly closed warehouse) should be provided on site for any unused bentonite that needs to be transported away after all the related construction activities area completed.  The requirements in ProPECC PN 2/23 should be adhered to in the handling and disposal of bentonite slurries.

48       To minimize construction water quality impact from tunnelling works

49       Contractor

50       All tunnelling portion

51       Construction stage

·   Water Pollution Control Ordinance

·   ProPECC PN 2/23

·   TM-DSS

·   TM-EIAO

52       N/A

S6.9.1.3

W3

Sewage Effluent

·    Portable chemical toilets and sewage holding tanks are recommended for handling the construction sewage generated by the workforce.  A licensed contractor should be employed to provide appropriate and adequate portable toilets and be responsible for appropriate disposal and maintenance.

53       To minimize water quality from sewage effluent

54       Contractor

55       All construction sites where practicable

56       Construction stage

·   Water Pollution Control Ordinance

·   TM-DSS

57       Implemented

S6.9.1.5

W4

Groundwater from Potential Contaminated Area:

·    No direct discharge of groundwater from contaminated areas should be adopted.

·    A discharge license under the WPCO through the Regional Office of EPD for groundwater discharge should be applied. Prior to the excavation works within these potentially contaminated areas, the groundwater quality should be reviewed during the process of discharge license application. The compliance to the Technical Memorandum on Standards for Effluents Discharged into Drainage on Sewerage Systems, Inland and Coastal Waters (TM-DSS) and the existence of prohibited substance should be confirmed. If the review results indicated that the groundwater to be generated from the excavation works would be contaminated, the contaminated groundwater should be either properly treated in compliance with the requirements of the TM-DSS or properly recharged into the ground.

·    If wastewater treatment is deployed, the wastewater treatment unit shall deploy suitable treatment process (e.g. oil interceptor / activated carbon) to reduce the pollution level to an acceptable standard and remove any prohibited substances (e.g. TPH) to undetectable range. All treated effluent from wastewater treatment plant shall meet the requirements as stated in TM-DSS and should be discharged into the foul sewers.

·    If groundwater recharging wells are deployed, recharging wells should be installed as appropriate for recharging the contaminated groundwater back into the ground. The recharging wells should be selected at places where the groundwater quality will not be affected by the recharge operation as indicated in the Section 2.3 of TM-DSS. The baseline groundwater quality shall be determined prior to the selection of the recharge wells, and submit a working plan (including the laboratory analytical results showing the quality of groundwater at the proposed recharge location(s) as well as the pollutant levels of groundwater to be recharged) to EPD for agreement. Pollution levels of groundwater to be recharged shall not be higher than pollutant levels of ambient groundwater at the recharge well. Prior to recharge, any prohibited substances such as TPH products should be removed as necessary by installing the petrol interceptor.

58       To minimize groundwater quality impact from contaminated area

59       Contractor

60       Excavation areas where contamination is found

61       Construction stage

·   Water Pollution Control Ordinance

·   TM-DSS

·   TM-EIAO

62       N/A

S6.9.1.6

W6

Accidental Spillage

In order to prevent accidental spillage of chemicals, the following is recommended:

·    All the tanks, containers, storage area should be bunded and the locations should be locked as far as possible from the sensitive watercourse and stormwater drains;

·    The Contractor should register as a chemical waste producer if chemical wastes would be generated.  Storage of chemical waste arising from the construction activities should be stored with suitable labels and warnings.

Disposal of chemical wastes should be conducted in compliance with the requirements as stated in the Waste Disposal (Chemical Waste) (General) Regulation.

63       To minimize water quality impact from accidental spillage

64       Contractor

65       All construction site where practicable

66       Construction stage

·   Water Pollution Control Ordinance

·   ProPECC PN 2/23

·   TM-EIAO

·   TM-DSS

67       N/A

68   Waste Management (Construction Waste)

S7.4.1

WM1

On-site sorting of C&D material

·    Geological assessment should be carried out by competent persons on site during excavation to identify materials which are not suitable to use as aggregate in structural concrete (e.g. volcanic rock, Aplite dyke rock, etc.).  Volcanic rock and Aplite dyke rock should be separated at the source sites as far as practicable and stored at designated stockpile area preventing them from delivering to crushing facilities.  The crushing plant operator should also be reminded to set up measures to prevent unsuitable rock from ending up at concrete batching plants and be turned into concrete for structural use.  Details regarding control measures at source site and crushing facilities should be submitted by the Contractor for the Engineer to review and agree.  In addition, site records should also be kept for the types of rock materials excavated and the traceability of delivery will be ensured with the implementation of Trip Ticket System and enforced by site supervisory staff as stipulated under DEVB TC(W) No. 6/2010 for tracking of the correct delivery to the rock crushing facilities for processing into aggregates.  Alternative disposal option for the reuse of volcanic rock and Aplite Dyke rock, etc. should be explored.

69       Separation of unsuitable rock from ending up at concrete batching plants and be turned into concrete for structural use

70       Contractor

71       All construction sites

72       Construction stage

·   DEVB (W) No. 6/2010

73       N/A

S7.5.1

WM2

Construction and Demolition Material

·    Maintain temporary stockpiles and reuse excavated fill material for backfilling and reinstatement;

·    Carry out on-site sorting;

·    Make provisions in the Contract documents to allow and promote the use of recycled aggregates where appropriate;

·    Adopt ‘selective demolition’ technique to demolish the existing structures and facilities with a view to recovering broken concrete effectively for recycling purpose, where possible;

·    Implement a trip-ticket system for each works contract to ensure that the disposal of C&D materials is properly documented and verified; and

·    Implement an enhanced Waste Management Plan similar to ETWBTC (Works) No. 19/2005 – “Environmental Management on Construction Sites” to encourage on-site sorting of C&D materials and to minimize their generation during the course of construction.

74       Good site practice to minimize the waste generation and recycle the C&D materials as far as practicable so as to reduce the amount for final disposal

75       Contractor

76       All construction sites

77       Construction stage

·   Land (Miscellaneous Provisions) Ordinance

·   Waste Disposal Ordinance

·   ETWB TCW No. 19/2005

78       N/A

S7.5.1

WM3

C&D Waste

·    Standard formwork or pre-fabrication should be used as far as practicable in order to minimize the arising of C&D materials.  The use of more durable formwork or plastic facing for the construction works should be considered.  Use of wooden hoardings should not be used, as in other projects.  Metal hoarding should be used to enhance the possibility of recycling.  The purchasing of construction materials will be carefully planned in order to avoid over ordering and wastage;

·    The Contractor should recycle as much of the C&D materials as possible on-site. Public fill and C&D waste should be segregated and stored in different containers or skips to enhance reuse or recycling of materials and their proper disposal.  Where practicable, concrete and masonry can be crushed and used as fill.  Steel reinforcement bar can be used by scrap steel mills.  Different areas of the sites should be considered for such segregation and storage.

79       Good site practice to minimize the waste generation and recycle the C&D materials as far as practicable so as to reduce the amount for final disposal

80       Contractor

81       All construction sites

82       Construction stage

·   Land (Miscellaneous Provisions) Ordinance

·   Waste Disposal Ordinance

·   ETWB TCW No. 19/2005

83       N/A

S7.5.1

WM4

Excavated Contaminated Soils

·    Details of the mitigation measures on handling of the contaminated soil shall be referred to Section on Land Contamination below.

84       The contaminated soil will be

85       excavated for on-site reuse

86       Contractor

87       PBH4

88       Prior to

89       commencement of

90       construction

91       works within the contaminated

92       area

·   Practice Guide (PG) for Investigation and Remediation of Contaminated Land

·   GN/GM for land contamination

93       N/A

S7.5.1

WM5

Land-based Sediment

·    All construction plant and equipment shall be designed and maintained to minimize the risk of silt, sediments, contaminants or other pollutants being released into the water column or deposited in the locations other than designated location;

·    All vessels shall be sized such that adequate draft is maintained between vessels and the sea bed at all states of the tide to ensure that undue turbidity is not generated by turbulence from vessel movement or propeller wash;

·    Before moving the vessels which are used for transporting dredged material, excess material shall be cleaned from the decks and exposed fittings of vessels and the excess materials shall never be dumped into the sea except at the approved locations;

·    Adequate freeboard shall be maintained on barges to ensure that decks are not washed by wave action.

·    The Contractors shall monitor all vessels transporting material to ensure that no dumping outside the approved location takes place. The Contractor shall keep and produce logs and other records to demonstrate compliance and that journeys are consistent with designated locations and copies of such records shall be submitted to the engineers;

·    The Contractors shall comply with the conditions in the dumping license.

·    All bottom dumping vessels (Hopper barges) shall be fitted with tight fittings seals to their bottom openings to prevent leakage of material;

·    The material shall be placed into the disposal pit by bottom dumping;

·    Contaminated marine mud shall be transported by spit barge of not less than 750m3 capacity and capable of rapid opening and discharge at the disposal site;

·    Discharge shall be undertaken rapidly, and the hoppers shall be closed immediately. Material adhering to the sides of the hopper shall not be washed out of the hopper and the hopper shall remain closed until the barge returns to the disposal site.

·    For Type 3 special disposal treatment, sealing of contaminant with geosynthetic containment before dropping designated mud pit would be a possible arrangement. A geosynthetic containment method is a method whereby the sediments are sealed in geosynthetic containers and, the containers would be dropped into the designated contaminated mud pit where they would be covered by further mud disposal and later by the mud pit capping at the disposal site, thereby fulfilling the requirements for fully confined mud disposal.

94       To control pollution due to marine sediment

95       Contractor

96       Along CKR alignment

97       Construction stage

·   ETWB TCW No. 34/2002

98       N/A

S7.5.1

WM6

Chemical Waste

·   Chemical waste that is produced, as defined by Schedule 1 of the Waste Disposal (Chemical Waste) (General) Regulation, should be handled in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes;

·   Containers used for the storage of chemical wastes should be suitable for the substance they are holding, resistant to corrosion, maintained in a good condition, and securely closed, have a capacity of less than 450 L unless the specification has been approved by EPD, and display a label in English and Chinese in accordance with instructions prescribed in Schedule 2 of the regulation;

·   The storage area for chemical wastes should be clearly labelled and used solely for the storage of chemical waste, enclosed on at least 3 sides, have an impermeable floor and bunding of sufficient capacity to accommodate 110% of the volume of the largest container or 20% of the total volume of waste stored in that area, whichever is the greatest, have adequate ventilation, covered to prevent rainfall entering, and arranged so that incompatible materials are adequately separated;

·   Disposal of chemical waste should be via a licensed waste collector, be to a facility licensed to receive chemical waste, such as the Chemical Waste Treatment Centre which also offers a chemical waste collection service and can supply the necessary storage containers, or be to a reuser of the waste, under approval from EPD.

99       Control the chemical waste and ensure proper storage, handling and disposal

100    Contractor

101    All construction sites

102    Construction stage

·   Waste Disposal (Chemical Waste) (General) Regulation

·   Code of Practice on the Packaging, Labelling and Storage of Chemical Waste

103    N/A

S7.5.1

WM7

General Refuse

·   General refuse generated on-site should be stored in enclosed bins or compaction units separately from construction and chemical wastes;

·   A reputable waste collector should be employed by the Contractor to remove general refuse from the site, separately from construction and chemical wastes, on a daily basis to minimize odour, pest and litter impacts.  Burning of refuse on construction sites is prohibited by law.

·   Aluminium cans are often recovered from the waste stream by individual collectors if they are segregated and made easily accessible.  Separate labelled bins for their deposit should be provided if feasible;

·   Office wastes can be reduced through the recycling of paper if volumes are large enough to warrant collection.  Participation in a local collection scheme should be considered by the Contractor.

104    Minimize production of the general refuse and avoid odour, pest and litter impacts

105    Contractor

106    All construction sites

107    Construction stage

·   Waste Disposal Ordinance

108    N/A

109 Hazard to Life

S9.18

H8

The driver and his assistant should be physically healthy, experienced and have good safe driving records.  The driver should hold a proper driving licence for the approved transport truck.  Dedicated training programme and regular road safety briefing sessions/ workshops should be provided to enhance their safe driving attitude and practice.  Smoking should be strictly prohibited.

To reduce the risk during explosives transport

Contractor

Works areas at which explosives would be used

Construction stage

-

110    N/A

S9.18

H9

Emergency response plans in case of road accident should be prepared and implemented.  The driver and his assistant should be familiar with the emergency procedures including evacuation, and proper communication/ fire-fighting equipment should be provided to the driver and his assistant.

To reduce the risk during explosives transport

Contractor

Works areas at which explosives would be used

Construction stage

-

111    N/A

112 Landscape & Visual

S10.10.1 Table 10.11

LV3

113          Good Site Management

·   Large temporary stockpiles of excavated material shall be covered with unobtrusive sheeting to prevent dust and dirt spreading to adjacent landscape areas and vegetation, and to create a neat and tidy visual appearance.

·   Construction plant and building material shall be orderly and carefully stored in order to create a neat and tidy visual appearance.

Minimize visual impact

Contractor

Within Project site

Construction stage

-

114    N/A

S10.10.1 Table 10.11

LV4

115          Screen Hoarding

·   Decorative screen hoarding should be erected to screen the public from the construction area.  It should be designed to be compatible with the existing urban context.

Minimize visual impact

Contractor

Within Project site

Construction stage

-

116    N/A

S10.10.1 Table 10.11

LV5

117          Lighting Control during Construction

·   All lighting in the construction site shall be carefully controlled to minimize light pollution and night-time glare to nearby residencies and GIC.  The Contractor shall consider other security measures, which shall minimize the visual impacts.

Minimize visual impact

Contractor

Within Project site

Construction stage

-

118    N/A

S10.10.1 Table 10.11

LV6

119          Erosion Control

·   The potential for soil erosion shall be reduced by minimizing the extent of vegetation disturbance on site and by providing a protective cover over newly exposed soil.

120 Minimize landscape impact

121 Contractor

122     Within Project site

123     Construction stage

-

124    N/A

S10.10.1 Table 10.11

LV7

125          Tree Protection & Preservation

·   Carefully protected during construction.  Tree protection measures will be detailed at the Tree Removal Application stage and plans submitted to the relevant Government Department for approval in due course in accordance with ETWB TC No. 3/2006.

126 Minimize landscape and visual impact

127 Contractor

128     Within Project site

129 Construction stage

·   ‘Guidelines for Tree Risk Management and Assessment Arrangement on an Area Basis and on a Tree Basis’, Greening, Landscape and Tree Management (GLTM) Section, DEVB

·   Latest recommended horticultural practices from GLTM Section, DEVB

130    N/A

S10.10.1 Table 10.11

LV8

131          Tree Transplantation

·   For trees unavoidably affected by the Project that have to be removed, where practical transplantation will be chosen as the top priority method of removal.  If this is not possible or practical compensatory planting will be provided for trees unavoidably felled (See LV10).  For trees unavoidably affected by the Project works that are transplanted, transplantation must be carried out in accordance with ETWB TCW 2/2004 and 3/2006.

132 Minimize landscape and visual impact

133 Contractor

134     Within Project site and designated off-site locations

135     Prior to Construction stage

·   ETWB TCW 3/2006

·   Latest recommended horticultural practices from Greening, Landscape and Tree Management (GLTM) Section, DEVB

·   ETWB TCW 2/2004

136    N/A

S10.10.1 Table 10.11

LV9

137          Compensatory Planting

·    For trees unavoidably affected by the Project that have to be removed, where practical transportation will be chosen as the top priority method of removal but if this is not possible or practical compensatory planting will be provided for trees unavoidably felled.  All felled trees shall be compensated for by planting trees to the satisfaction of relevant Government projects.  Required numbers and locations of compensatory trees shall be determined and agreed separately with Government during the Tree Felling Application process under ETWB TC 3/2006.

·    Compensatory tree planting may be incorporated into public open spaces and along roadside amenity areas affected by the construction works and therefore be part of the bigger wider planting plans.  Onsite compensation planting is preferred but, if necessary, additional receptor sites outside the Works Area shall be agreed separately with the Government during the Tree Felling Application process.

138 Minimize visual impact and also enhance landscape

139 Contractor

140     Within Project site

141     Construction stage

·   ETWB TCW 3/2006

·   Latest recommended horticultural practices from Greening, Landscape and Tree Management (GLTM) Section, DEVB

·   ETWB TCW 2/2004

142    N/A

S10.10.1

Table

10.11

LV10

143          Screen Planting

·    Tall screen/buffer trees, shrubs and climbers should be planted, in so far as is possible, to soften and screen proposed structures such as roads and central strip, vertical edges and buildings and to enhance streetscape greening effect where appropriate. Indiscriminate use of trees for screening must be avoided and the principle of ‘right tree for the right place’ must be followed. This detail will be provided at the Detailed Design stage. This measure may additionally form part of the compensatory planting and will improve and create a pleasant pedestrian environment.

144 Minimize visual impact and

145 also enhance landscape.

146 Contractor

147     Within

148     Project Site

149     Construction

150     Phase

·   Guidelines on Greening of Noise Barriers, issued April 2012, GLTMS, DevB

·   ETWB TCW 2/2004

151    N/A

S10.10.1

Table

10.11

LV12

152          Reinstatement

·    All works areas, excavated areas and disturbed areas for tunnel construction and temporary road diversion or any other proposed works shall be reinstated to former conditions or better, with reasonable landscape treatment and to the satisfaction of the relevant Government departments. (Specific mitigation for disturbance to public open space is detailed separately under LV14.)

Minimize landscape impact

Contractor

153     Within

154     Project Site

155     Construction

156     Phase

·   N/A

157 N/A

158 Cultural Heritage Impact (Construction Phase)

S11.4.4

CH1

The contractor should be alerted during the construction on the possibility of locating archaeological remains and as a precautionary measure, AMO shall be informed immediately in case of discovery of antiquities or supposed antiquities in the subject sites.

To preserve any cultural heritage items which may be removed and damaged by the excavation

Contractor

During construction works for cut and cover tunnels

Construction stage

·   AMOs requirements

N/A

159      EM&A Project

S13.2

EM1

An Independent Environmental Checker needs to be employed as per the EM&A Manual

Control EM&A Performance

Highways Department

All construction sites

Construction stage

·   EIAO Guidance Note No. 4/2010

·   TM-EIAO

160    Implemented

S13.2-13.4

EM2

·    An Environmental Team needs to be employed as per the EM&A Manual;

·    Prepare a systematic Environmental Management Plan to ensure effective implementation of the mitigation measures;

·    An environmental impact monitoring needs to be implemented by the Environmental Team to ensure all the requirements given in the EM&A Manual are fully complied with.

Perform environmental monitoring & auditing

Highways Department/ Contractor

All construction sites

Construction stage

·   EIAO Guidance Note No. 4/2010

·   TM-EIAO

161    Implemented

Appendix G

Waste Flow Table

A screenshot of a document

Description automatically generated

Appendix H

Statistics on Complaint, Notifications of Summons and Successful Prosecution

Statistical Summary of Environmental Complaints

Reporting Period

Environmental Complaint Statistics

Frequency

Cumulative

Complaint Nature

11 November 2024

-

30 November 2024

0

0

N/A

Statistical Summary of Environmental Non-compliance

Reporting Period

Environmental Non-compliance Statistics

Frequency

Cumulative

Details

11 November 2024

-

30 November 2024

0

0

N/A

Statistical Summary of Environmental Summons

Reporting Period

Environmental Summons Statistics

Frequency

Cumulative

Details

11 November 2024

-

30 November 2024

0

0

N/A

Statistical Summary of Environmental Prosecution

Reporting Period

Environmental Prosecution Statistics

Frequency

Cumulative

Details

11 November 2024

-

30 November 2024

0

0

N/A

A white paper with black text

Description automatically generated
